Electricity market

The energy sector is developing rapidly. The process of European market integration began some years ago. Its purpose is to create a single European market that enables market parties to trade gas and electricity across national borders easily and efficiently.

Explore the electricity market

Transparency data

We provide transparency data on our operations on our Dutch and German transparency page and on ENTSO-E.

To transparency pages
E-Insights

Our vision is to be one of the most transparent Transmission System Operators (TSO) in Europe and thereby creating value for society. In this Energy Insights section we present selected energy related topics and show data, information and valuable insights.

E-Insights

E-Insights

Facts & figures related to TenneT facilitating the market can be found here.

Read more
News News Corporate Project Safety

Installation of transformer platform can be carried out as planned - Research confirms: limited damage to foundations of Hollandse Kust (zuid)

Downloads & Contact

The installation of the second offshore transformer platform for the grid connection of wind farm Hollandse Kust (zuid) can be carried out as planned. TenneT has had investigations carried out on the jacket (substructure) that was damaged in January during storm Corrie by a collision with the adrift vessel Julietta D.

The investigation shows that the damage to the jacket is limited. The damaged parts of the jacket can be repaired at a later stage after topside installation. TenneT expects the Hollandse Kust (zuid) Beta topside to be installed at the end of March or early April.

Collision during storm

On Monday 31 January, the freighter Julietta D. was adrift due to storm Corrie in the area where TenneT is building two transformer platforms (Hollandse Kust (zuid) Alpha and Beta). These transformer platforms are part of the offshore connection of wind farm Hollandse Kust (zuid). The wind farm is being built by Vattenfall. The cargo ship collided with the Beta jacket. No people were working at the platform at that moment.

Stormy weather in February

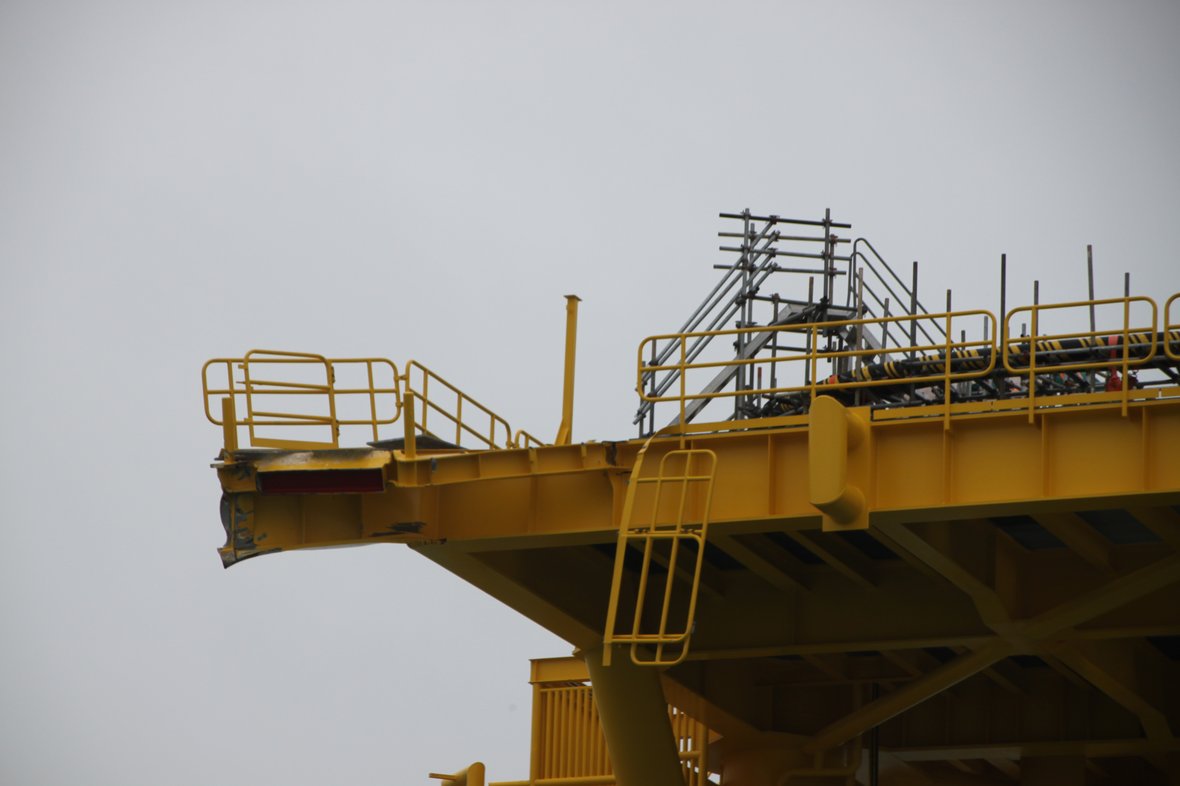

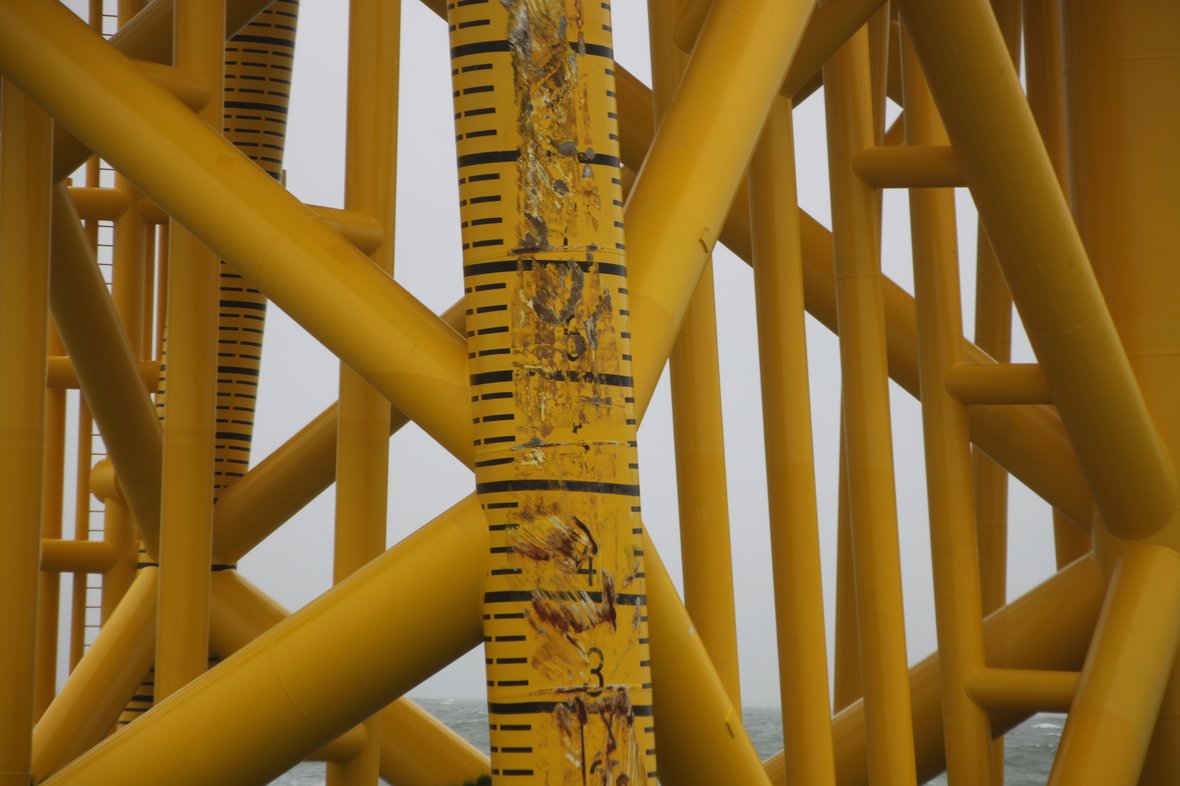

The persistent stormy weather in February meant that inspections of the damage could not be carried out immediately. In addition to the inspection of visible damage above water, underwater investigations were also carried out to determine any damage to the substructure. This underwater investigation took more time due to relatively high waves and poor visibility. The investigation now shows that the damage is limited to paint damage and a few dents on one of the legs of the platform and damage to one of the four landing platforms for working vessels.

Safe installation

Joris Engelen, TenneT's Platform Project Lead: "When designing and building our jackets, scenarios are taken into account that a ship of limited size may collide with the jacket. After the initial fright of the collision, we set up and implemented an extensive investigation plan in cooperation with the parties involved. The jacket is expected to be in operation for many years. We are therefore relieved that the inspections and the investigations show that we can install the top side of the transformer platform on the jacket safely and as scheduled. After the top side has been installed, the repairs of the damages on the jacket can be carried out." The top side is currently being shipped to its destination in the North Sea. TenneT expects that the top side can be installed at the end of March or beginning of April.
